SynMax Vulcan UC Weekly Project Monitoring Update (Client Only)



Last week, SynMax observed land clearing activities at five project sites. We also confirmed land clearing at a 114 MW wind plant project in PJM, which began in October of last year. These observations resulted in an improved project ranking for each site.

Detailed information, including the latest earliest online dates and projected scenario online dates, is accessible to clients via API, Snowflake, or our user interface (UI).

Below is a sample of the data. Notably, three large-scale power projects, totaling 850 MW, are now confirmed to be under construction. These projects were not previously listed as such by the EIA and are now expected to come online as early as October 2025.

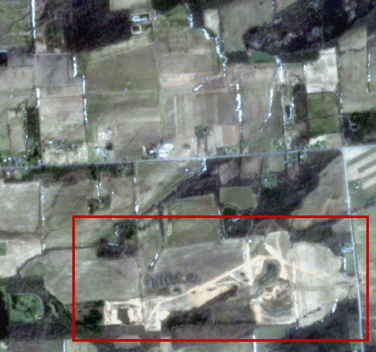

64163 Hecate Energy Cider Solar LLC, 500 MW Solar, Genesee County NY

EIA Status: (P) Planned for installation, Planned Operation: 12/2025

Projected Online V1: 2/15/2026 V2: 2/1/2026 Ranking: 3.48

                                             3/14/2025

                        Picture1-4        Picture2-3

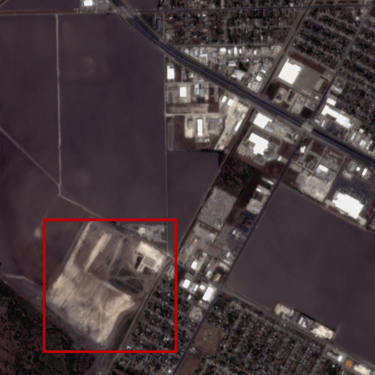

67768 Cumbia Energy Center, 200 MW Battery, Nueces County TX

EIA Status: (P) Planned for installation, Planned Operation: 5/2027

Projected Online V1: 3/23/2028 V2: 5/1/2027 Ranking: 4.04

                                                              3/17/2025

                          Picture3-3         Picture4-2

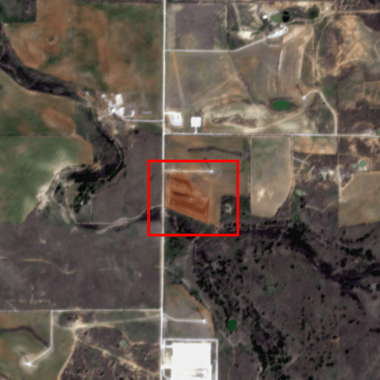

68460 Roadrunner Crossing Energy Storage LLC, 150 MW Solar, Eastland County TX

EIA Status: (P) Planned for installation, Planned Operation: 12/2025

Projected Online V1: 3/10/2026 V2: 12/1/2025 Ranking 4.59

                                                                   3/17/2025

                             Picture6-1          Picture7
