Skip to content

Datacenter Delays are a $3 Billion Earnings Problem-And Most of It Hasn't Hit Yet

SynMax Research

What This Report Tells You

If you're invested in, supplying to, or building data centers, construction delays are quietly repricing your earnings outlook. This week, using SynMax Agents and the Vulcan dataset, we quantified that impact — and the picture is more front-loaded than the market currently expects.

What you'll take away: where the delays are, whose earnings are most exposed, and how satellite-verified construction data changes what you think you know about project timelines.

The Scale of the Problem

Over $3 trillion is being allocated to data center infrastructure globally. Publicly traded companies alone have announced more than 50 GW of new U.S. capacity expected online by 2030. The problem: much of that is planned, not under construction. When there's no signal of activity — no land clearing, no first structure — timing projections become guesswork.

We defined a "delay" as a project's actual construction progress versus the online date committed in earnings guidance or as tracked by our partner IIR Energy. To translate delays into dollar impact, we use revenue-per-MW benchmarks by company tier:

Tier

Companies

Revenue ($/MW/quarter)

Hyperscaler

AMZN, GOOGL, MSFT, META, ORCL

$3.50M

GPU Cloud

IREN, CIFR

$5.00M

Colo / REIT

DLR, EQIX, IRM, PLD

$0.57M

Benchmarks derived from ~916 H100-equivalent GPUs/MW × $3–6/GPU-hr (hyperscaler/GPU cloud); Colo rate from DLR/EQIX wholesale lease economics in 10-Qs.

What the Data Shows

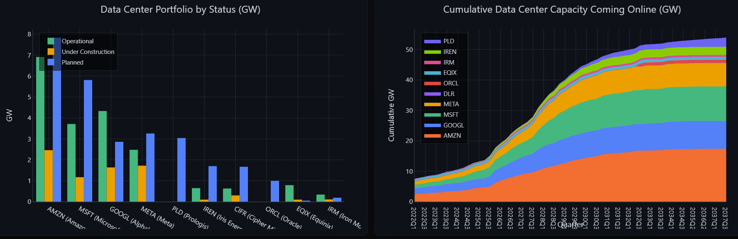

The cumulative earnings impact from current delays reaches over $3 billion by end of 2027.

The near-term picture is counterintuitive: for the next few quarters, several projects are actually tracking ahead of public expectations, which means potential beats. But as the year progresses, the math reverses. A large cluster of projects — roughly 4.5 GW — has been deferred to late 2027, pushing the earnings reckoning down the calendar. That deferral absorbs a lot of pain on paper. The catch: 50% of projects that were originally guided as Q4 2025 deliveries land cleared already by June of 2024. This is not happening for much of the Q4 2027 projects.

At the company level:

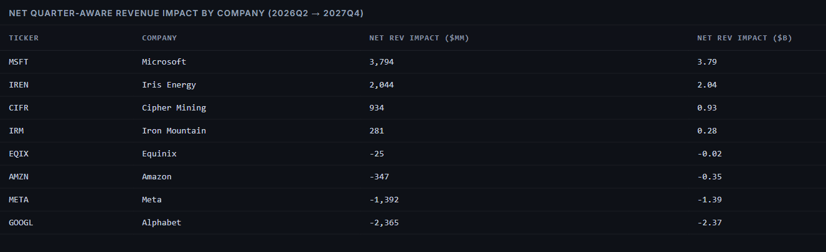

  • Microsoft is carrying the most aggressive timeline assumptions relative to what Vulcan's satellite analysis currently shows on the ground.
  • Google is running conservative — and demonstrating one active hedge: rather than wait on builds, Google signed an approximately $30 billion deal to rent 110,000 GPUs at xAI/SpaceX's Colossus 2 facility in Southaven, MS, at roughly $920M/month through June 2029. Acquiring or contracting existing capacity is the clearest workaround for any company running behind its own guidance.

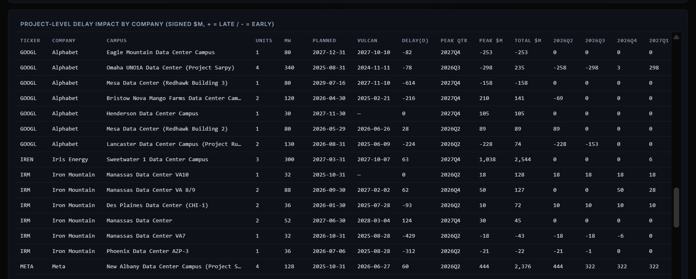

The full company-by-project matrix — showing which publicly traded operators are most exposed to delay-driven earnings revisions — is available on the Vulcan platform.

What Changed This Week

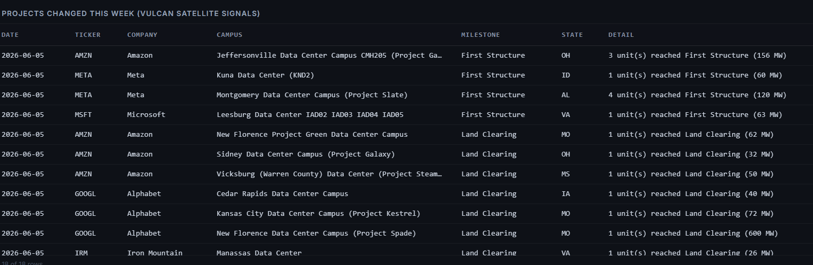

Vulcan tracks construction progress continuously. Last week alone, 18 project-level changes were recorded: 4 first-structure events and 14 land-clearing events. Each of those is an earnings signal the market hasn't priced yet.

What You Can Do With This

The difference between a projected online date and a real one is now measurable — not from filings, but from what's actually happening on the ground. Vulcan's weekly progress indicator gives you construction momentum by project, enabling more precise online-date forecasting before guidance revisions surface in earnings calls.

If you are not a client and you want to see the company-by-project delay matrix or run a scenario on a specific name, reach out to David Bellman dbellman@synmax.com

Direct Intelligence at Your Fingertips

Vulcan pairs satellite monitoring with on-site thermal drone verification, providing the ground truth needed to look past reported milestones.

  • You direct our intelligence gathering. Vulcan runs 1 to 2 dedicated thermal drone flights per week based on subscriber demand. Submit site suggestions or commission targeted flyovers to validate your highest-conviction positions.

  • Send drone flight suggestions to David Bellman at dbellman@synmax.com.

About SynMax Vulcan

Vulcan monitors U.S. power generation, datacenter, and LNG projects using satellite imagery to independently verify construction status and predict online dates — separate from official EIA estimates. Coverage includes project-level ranking (0–7), weekly progress indicators, and completion detection.

For API access, data licensing, or questions about this analysis, contact the SynMax research team.
